How Long Does a Fibreglass Pool Installation Really Take? The Honest Timeline
Seven days. That's the number that tends to circulate online, and technically, for the physical act of sinking a shell into the ground, it's not wrong. But if you've just started planning your backyard pool and you're operating on the assumption that you'll be swimming in a week's time, this article might save you a very frustrating few months.
The truth is that fibreglass pool installation time isn't a single number. It's a series of phases, each with its own timeline, its own variables, and its own potential for delay. Understand all of them upfront, and you'll plan better, stress less, and be in the water by the date you're aiming for.
Here's the complete, phase-by-phase breakdown - no fluff, no vague estimates, just the honest timeline Australian homeowners need.
|
Fibreglass Pool Installation Time - Quick Answer The physical installation of a fibreglass pool shell typically takes 5-14 days. However, the total project timeline from first enquiry to first swim, including approvals, manufacturing, and finishing works, is realistically 4-9 months, depending on the time of year and your site conditions. |
The Number Everyone Quotes (And Why It's Misleading)
Ask most people how long a fibreglass pool takes and they'll say "about a week." Ask the ones who've been through the process and they'll laugh, not because it's a nightmare, but because a week only tells part of the story.
The physical installation, excavation, crane delivery, plumbing, backfilling, and filling are genuinely fast. It's one of the great advantages fibreglass has over concrete, which can take 12-16 weeks to build in the ground. But the physical work doesn't begin until permits are issued and your shell is manufactured. And those two phases alone can take several months.
Here's the big picture before we break each phase down:
|
Phase |
Best Case |
Typical |
Peak Season (Oct–Feb) |
|---|---|---|---|
|
Phase 1: Planning & ordering |
1–2 weeks |
2–4 weeks |
2–4 weeks |
|
Phase 2: Permits & approvals |
2–3 weeks |
4–6 weeks |
6–10 weeks |
|
Phase 3: Shell manufacturing |
4 weeks |
4–6 weeks |
6–8 weeks |
|
Phase 4: Physical installation |
3–5 days |
7–14 days |
7–14 days |
|
Phase 5: Fencing, paving & landscaping |
1–2 weeks |
2–4 weeks |
4–6 weeks |
|
TOTAL: First enquiry to first swim |
~2–3 months |
~3–5 months |
~4–7 months |
The important takeaway: Phases 2 and 3 can run simultaneously. That's how DIY pool owners can shave months off the total. More on that shortly.
Phase 1: Planning, Design & Ordering (Weeks 1–4)
Before anything physical happens, you need to choose your pool. And while that sounds simple, it's worth giving it proper time rather than rushing a decision you'll live with for decades.
During this phase you'll be settling on shell shape, size, colour, and orientation in your yard. You'll be confirming site access - whether a crane or excavator can physically reach your backyard. And you'll be placing your order with CFPK, which kicks off the manufacturing clock.
Things that slow Phase 1 down:
-
Undecided on shell size or model (our range spans plunge pools through to full-length family pools)
-
Uncertain about backyard layout - whether a rectangular or freeform design suits the space
-
Waiting on a surveyor or council pre-approval check before committing
-
Site access that needs early assessment (narrow side access, overhead powerlines, sloped block) CFPK can assist with this over the phone.
Pro tip: Use this phase productively. While you're confirming your design, start gathering the documents you'll need for your permit application in Phase 2. Getting a head start here is the single biggest time-saver in the entire project.
→ Read more: Getting Started: Planning Your New DIY Fibreglass Pool
Phase 2: Building Permits & Council Approvals (Weeks 2–10)
This is the phase that catches most first-time pool buyers off guard and it's the one where the timeline varies most between homeowners.
Every new swimming pool in Australia requires a Building Permit before any ground is broken. There are no shortcuts around this, and no legitimate installer should begin excavation without one in hand. The approval process, however, differs significantly between states and between approval pathways.
What approvals does a fibreglass pool actually need?
At minimum, you'll need a Building Permit covering the pool shell, plumbing, filtration, and the associated safety barrier (pool fence). Depending on your site, you may also need:
-
A Planning Permit — if your block has overlays such as bushfire zones, flood-prone land, or heritage listings
-
An Asset Protection Permit — required by many councils before construction machinery crosses the nature strip
-
Build-Over-Easement consent — if your pool footprint is near a sewer, stormwater, or power easement on your title
Your council or a licensed Building Certifier/Surveyor can advise which of these apply to your specific site. When in doubt, ask early as finding out mid-application adds weeks.
Fast-track vs. full council approval: what's the difference?
Across Australia, pool approvals generally fall into one of two categories and understanding the difference can save you weeks.
Fast-track approval: Most states allow straightforward residential pools to bypass the full council assessment process, provided the design meets a set of pre-approved standards (setbacks, lot size, pool position, and so on). This pathway is assessed by a private certifier or building surveyor rather than your council, and approvals can often be issued in as little as 2–4 weeks. In NSW this is called a Complying Development Certificate (CDC); in other states it operates under different names and legislation. The result is the same: faster approval, less back-and-forth.
Full council approval (Development Application): Required when a pool doesn't meet the fast-track criteria. For example, on heritage-listed land, a bushfire-prone lot, a flood overlay, or a site with unusual setback constraints. These applications go to council for a merit-based assessment and typically take 6-10 weeks, sometimes longer if neighbouring properties are notified or additional reports are required.
Which pathway applies to you depends on your state, your local council area, and your specific site. The good news: the majority of standard fibreglass pool installations on typical residential blocks qualify for the faster route. Check with your local council or a licensed certifier early. It's a quick conversation that can significantly change your timeline.
How a private certifier or building surveyor speeds things up
Regardless of your state, engaging a licensed private certifier or registered building surveyor, rather than lodging directly with council, is one of the most effective ways to reduce approval wait times. A certifier assesses your application independently, which removes your project from the council queue entirely. In Victoria, for example, well-prepared documentation submitted to a private building surveyor can result in a Building Permit being issued within 1–2 weeks. In NSW, a private certifier can issue a CDC in as little as 20 days.
CFPK's support team can point you in the right direction for your state. It's worth having this conversation early, ideally before Phase 3 begins.
→ NSW homeowners: DIY Fibreglass Pools in NSW: Navigating Council Approvals Without the Headaches
→ Brisbane homeowners: DIY Fibreglass Pools in Brisbane: How to Get Council Approval Without the Headaches
Here's a state-by-state guide to the approval pathway and typical timeframes for a standard residential fibreglass pool with complete documentation:
|
State / Territory |
Primary Approval Body |
Typical Timeframe |
|---|---|---|
|
NSW |
Private certifier (CDC) or council (DA) |
3–6 weeks (CDC); 6–10 weeks (DA) |
|
VIC |
Registered Building Surveyor (private or municipal) |
2–5 weeks |
|
QLD |
Private certifier or local council |
2–8 weeks |
|
WA |
Building Services Board / local council |
4–8 weeks |
|
SA |
Council (Development Approval required for most pools) |
4–8 weeks |
|
ACT |
Licensed Building Surveyor (Certificate of Occupancy & Use required on completion) |
3–6 weeks |
Note: Timeframes above are indicative. Delays are common during peak season (spring/summer) when certifiers and councils process significantly higher volumes of pool applications. Always verify current timeframes with your certifier or local council before building your project schedule.
Phase 3: Shell Manufacturing (Weeks 4–20)
One of the most misunderstood parts of the fibreglass pool installation timeline is the manufacturing lead time. Your pool shell isn't sitting in a warehouse waiting for you; it's made to order in an Australian factory.
This means that from the moment you confirm your order, there's a production queue to work through. How long the queue is depends almost entirely on the time of year:
|
Season |
Typical Manufacturing Lead Time |
Why |
|---|---|---|
|
Autumn / Winter (Mar–Aug) |
4–6 weeks |
Lower demand; faster factory throughput |
|
Spring / Early Summer (Sep–Nov) |
4–6 weeks |
Demand rising; queues building |
|
Peak Summer (Dec–Feb) |
6–8 weeks |
Maximum demand; factories at capacity |
Because fibreglass shells are built in climate-controlled factory environments, manufacturing itself isn't affected by weather, a major advantage over concrete pools, where rain and wind can halt outdoor construction for days at a time.
The critical insight here: Phase 3 and Phase 2 can and should run at the same time. Place your order and simultaneously lodge your permit application. If your permit takes six weeks and manufacturing takes fourteen weeks, your shell arrives with eight weeks to spare, not six weeks after the permit. That simple piece of planning can save you almost two months.
[CFPK policy is the deposit is fully refundable if the permit application is declined by council for technical reasons which gives customers the confidence to run the concurrent process of ordering and permits without financial risk.
Phase 4: The Physical Installation (Days 1–14)
Here it is, the part people picture when they imagine pool installation. And it really is fast. For a standard in-ground fibreglass pool on a typical residential block, the physical work typically runs 5-14 days from the first excavator arriving to the pool being filled and operational.
What happens each day?
Day 1 - Site preparation & excavationThe excavator arrives and begins digging to the precise dimensions of your shell. On a flat block with good soil, this takes no more than a single day. Soil is removed from the site (typically via truck), and temporary fencing is erected for site safety. Your local council or certifier may require an inspection of the excavation before the shell goes in.

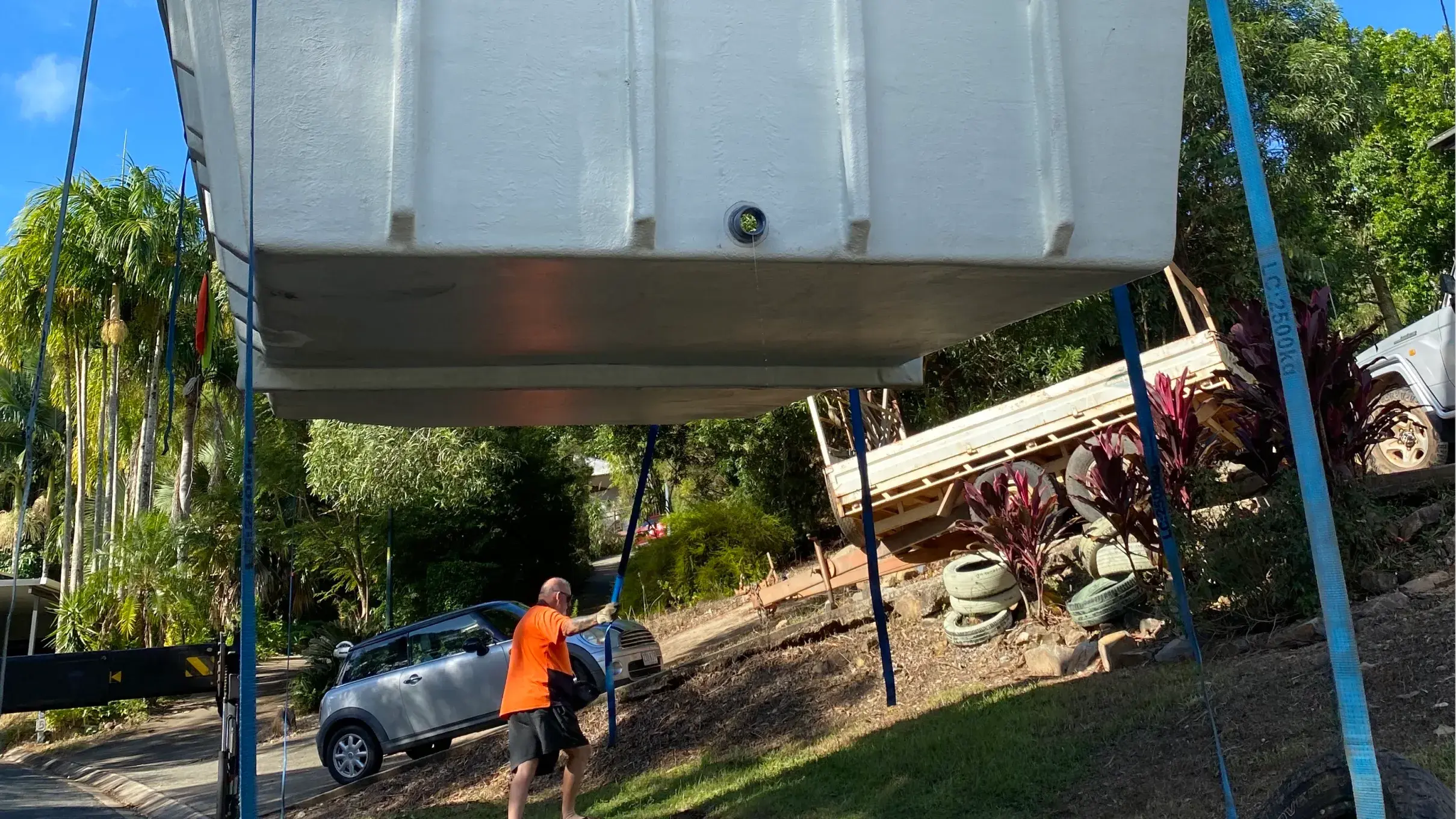

Day 2 - Shell delivery & crane placement
Your fibreglass shell is transported to site on a truck and craned into the excavated hole. This is the moment most homeowners pull out their phones for time-lapse footage. The crane positions the shell in the excavation. Pre-plumbing and lighting connections are made, and the shell is levelled.
Pipework is run from the shell to the equipment pad and filtration, heating (if applicable), and lighting are installed. Backfilling begins simultaneously with filling the pool with water - this is critical. The water pressure must balance the backfill pressure to prevent the shell from bowing or lifting. Both proceed incrementally in tandem.
Days 4–14 - Completion, inspection & commissioningThe backfill is completed. Concrete bond beam installed. Surrounds are graded. Equipment is commissioned and water chemistry is balanced. A final inspection by your Building Surveyor or Certifier is required before the pool can be lawfully used. Once that sign-off is in hand, the pool is yours. As long as compliant temporary fencing remains in place, the pool can be legally used. The certifier won’t complete their inspection until permanent pool fencing has been installed. Permanent fencing won’t be installed until paving has been completed which often takes up to two weeks to do.
Days 11–14 — Buffer for trades coordination
In reality, getting your electrician and plumber to site precisely when needed adds a small buffer to most projects. Allow a full two weeks as your planning assumption, and treat anything faster as a pleasant surprise.
What site conditions affect the installation timeline?
Not all backyards are created equal. These are the variables that most commonly add time to the physical installation phase:
|
Site condition |
Typical time added |
Notes |
|---|---|---|
|
Sloped or terraced block |
2–5 days |
Extra excavation and possible retaining walls required |
|
Rock or hard clay subsoil |
1–4 days |
Specialist rock-breaking equipment may be needed |
|
Restricted side access (<2.5m) |
1–3 days |
Smaller excavation machinery required; slower removal of spoil |
|
Complex crane access (overhead wires, narrow driveway) |
0.5–2 days |
Requires pre-visit assessment and possibly a different crane configuration |
|
High water table |
1–3 days |
Dewatering during excavation may be required [council permit will insist on the pool being installed above the water table. Dewatering is not permitted. The additional time comes from adding additional bedding material and stabilising piers] |
|
Trees to remove or roots to clear |
1–2 days |
Council approval for removal may also be needed |
The best way to surface these variables early is a pre-installation site assessment. CFPK's installer network and support team can help you identify potential complications before they become delays.
→ Learn more: What Is Normally Included With DIY Pool Installation?
Phase 5: Fencing, Paving & Landscaping (Days 3–21 Post-Installation)
Your pool may be in the ground and full of water, but you can't legally swim in it yet. Before your first swim is permitted, a compliant pool safety barrier must be in place and inspected. This is a non-negotiable requirement under Australian law and the relevant Australian Standard (AS 1926.1-2012 - Safety barriers for swimming pools).
Temporary vs. permanent fencing
During the installation itself, a temporary safety barrier is erected on the first day of excavation as required by law. The permanent pool fence, however, is a separate trade and must be completed and certified before you can use the pool.
Most fencing contractors can complete a standard residential pool fence within 1–2 days once they're on site. The wait is usually in their scheduling queue, particularly during peak season.
Paving and landscaping
These are finishing touches rather than legal prerequisites, but most homeowners want them done before they consider the project complete. Realistic timeframes:
-
Basic concrete surrounds: 3–5 days (including cure time before use)
-
Pavers or natural stone: 3–7 days
-
Full landscaping (turf, garden beds, decking): 1–3 weeks
-
Outdoor entertaining area or pergola additions: 2–4 weeks
A useful note: unlike concrete pools, fibreglass backfill can often accommodate landscaping immediately post-installation, without a long curing period. Your installer will advise on specifics for your site.
→ For pool type comparisons: What Is the Easiest Type of Pool to Install?
What Can Delay Your Timeline (And By How Much)?
Even the best-planned pool project runs into the occasional hiccup. Here are the most common delay factors and honest estimates of how much time each one typically adds:
|
Delay factor |
Typical time added |
How to minimise it |
|---|---|---|
|
Permit application submitted incomplete |
2–4 weeks |
Use a licensed certifier who prepares the documentation for you |
|
Peak-season permit queues |
2–6 weeks |
Start the approval process in winter; apply early |
|
Peak-season manufacturing queue |
2–4 weeks vs. off-peak |
Order your shell in autumn or winter |
|
Wet weather during excavation |
1–5 days |
Build a weather buffer into your schedule, especially in summer storm regions |
|
Subcontractor scheduling gaps (electrician, landscaper) |
3–14 days |
Book trades in advance; coordinate them before install day |
|
Unexpected rock or services during excavation |
2–7 days |
Arrange a soil type assessment before locking in your install date |
|
Fencing contractor backlog in peak season |
1–3 weeks |
Book your fencer at the same time as you order your pool |
A practical rule of thumb from experienced DIY pool owners: take your best estimate for the total timeline and add two weeks. That buffer absorbs the unexpected without disrupting your plans.
The Master Timeline: From Decision to First Swim
Pull it all together and here's what a realistic fibreglass pool project looks like end to end:
|
Scenario |
Total Timeline (First Enquiry to First Swim) |
|---|---|
|
Best case — off-peak order, fast approval, ideal site, quick trades |
~4 months |
|
Typical — spring order, standard approval, moderate site prep |
~5–6 months |
|
Peak season — summer order, busy certifiers, peak manufacturing queue |
~7–9 months |
When do I need to start planning to swim by summer?
This is the question every new pool buyer eventually asks. Working backwards from 1 December as your target swim date:
-
To swim by summer, place your order by late March to early April at the latest
-
For a relaxed timeline with buffer, aim to have your order confirmed and permit application submitted by the end of February
-
If you're reading this in October or November and want a summer pool, a DIY fibreglass pool may still be achievable but you'll want to act immediately and engage a certifier right away
→ Related reading: When Is the Ideal Season to Start Your DIY Fibreglass Pool Project?
Frequently Asked Questions
Can I get council approval and manufacturing happening at the same time?
Yes, and you should. This is one of the most effective ways to reduce your overall timeline. Once you've confirmed your shell choice and placed your order, immediately begin your permit application. In many cases, your permit will be approved before your shell is ready to be delivered, meaning there's no idle waiting time between phases.
What time of year is fastest for pool installation in Australia?
Autumn and winter (March to August) offer the shortest overall project timelines. Manufacturing lead times are 12–14 weeks rather than 16–20 weeks, permit queues are shorter, and installer availability is higher if using an installer. If you want to be swimming by the following summer, ordering in autumn is the smartest approach.
Does a DIY fibreglass pool take longer to install than a professionally installed one?
The physical installation timeline is essentially the same, whether you engage a licensed installer through CFPK or use a traditional pool company, the shell goes in the same way. What changes with the DIY pool model is who coordinates the trades and manages the timeline. With CFPK's support team available 7 days a week, most customers find the coordination straightforward. The main advantage is cost savings, not time.
What has to happen after installation before I can swim?
Before your first swim is legally permitted, your permanent pool safety barrier (fence) must be installed and certified as compliant with AS 1926.1-2012. A final inspection by your Building Surveyor or Certifier must also be completed and a sign-off issued. Water chemistry needs to be balanced. In most cases, this is achievable within 1–2 weeks of the physical installation being completed. [see above re temporary fencing and being able to use the pool.
|
Ready to Start Planning? Understanding the fibreglass pool installation time from end to end puts you in the best possible position to plan confidently. The earlier you start, the more control you have over the timeline and the more likely you are to be swimming exactly when you planned. Download CFPK's free pool planning e-guide for a full checklist of everything you need to know before you buy or request your personalised DIY pool kit quote today. |
Related Blogs
Planning a backyard pool for those scorching Perth summers? Smart thinking. With Perth hitting 30+ degrees regularly, a pool isn't just a nice-to-have, it's practically essential survival gear. DIY....
About The Author
My wife and I grew up playing in swimming pools. Our daughters learnt to swim in our backyard fibreglass swimming pool. There is nothing quite like hearing kids splashing about and giggling. As pools do, our pool became a social magnet for friends, family and neighbours which we loved. Helping customers to have their own pool and saving customers thousands on their pool and equipment is the best job in the world.
